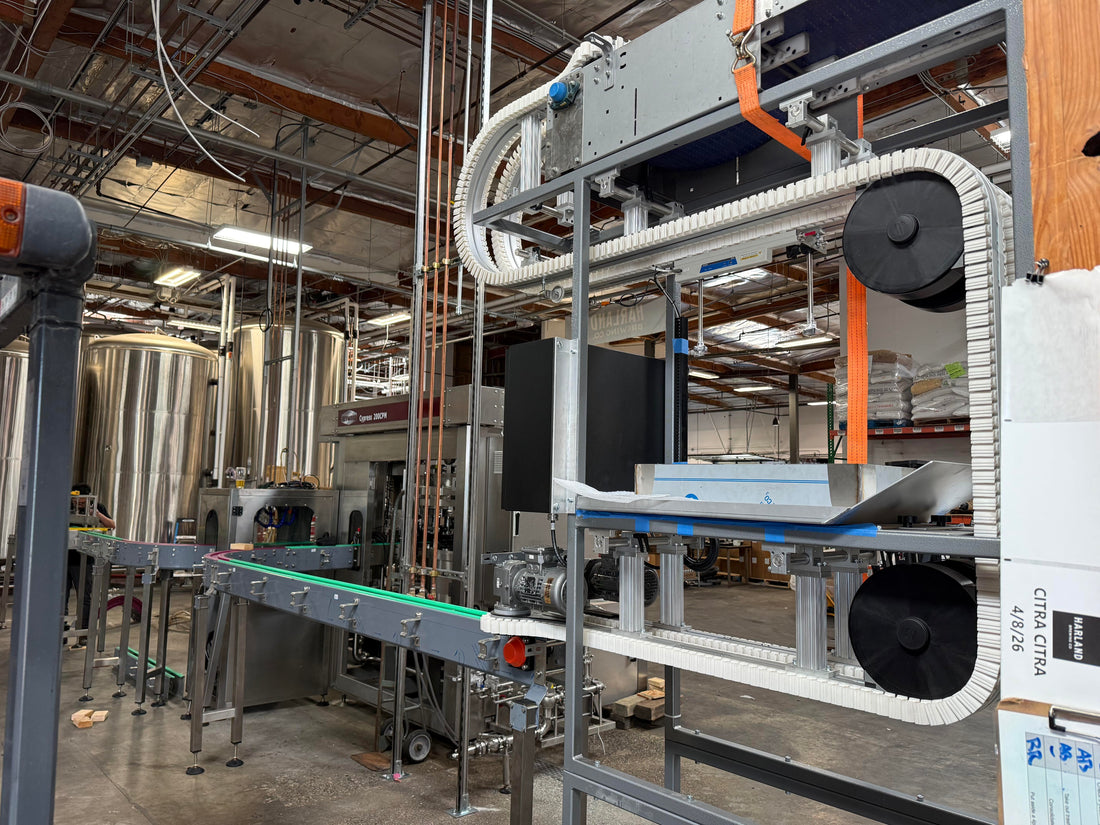

Choosing the Right Support and Commissioning Plan for a 100, 200, 300, or 600 CPM Canning Line

Choosing the Right Support and Commissioning Plan for a 100, 200, 300, or 600 CPM Canning Line

Selecting a high-speed canning line is not only a machinery decision. It is a production-system decision.

At 100, 200, 300, or 600 cans per minute, the filler and seamer must operate within a larger packaging workflow that may include beverage supply, can handling, conveyors, controls, inspection, operators and downstream packaging equipment. The support and commissioning plan should reflect that complete operating environment.

A useful buying discussion therefore goes beyond one question: How fast is the machine rated to run? It should also ask what must be defined, tested, prepared and handed over so the line can enter production successfully.

Important distinction  Rated CPM is a planning reference. Actual finished output depends on the product, container format, line configuration, material supply, changeovers, cleaning, operators and upstream or downstream conditions.

1. Begin With the Real Production Requirements

The right support plan begins with the production plan, not with a generic service package. Before selecting a line configuration, document how the operation is expected to run.

  •  Beverage types and relevant product conditions
  •  Can and lid formats
  •  Packaged volume per production run
  •  Packaging frequency and available production hours
  •  Expected product or format changeovers
  •  Available operators and maintenance resources
  •  Current upstream and downstream equipment
  •  Short- and long-term growth plans

These inputs help determine not only the appropriate CPM option, but also the level of integration, factory testing, documentation, training and startup support the project may require.

2. Match the Support Plan to the Selected Line

Redwood offers specific high-speed canning line options at 100, 200, 300 and 600 CPM. A buyer should not assume that the same support plan fits every project simply because the equipment belongs to the same product family.

As line speed, automation and connected equipment increase, coordination typically becomes more important. The project team may need to review more interfaces, controls sequences, accumulation points, operator responsibilities and facility requirements. The exact scope should be defined around the selected equipment and the customer’s production environment.

A smaller or less complex configuration may require a more focused startup plan. A highly integrated project may require broader testing, documentation and coordination. The correct choice is the scope that supports reliable operation without adding unnecessary complexity.

3. Review the Complete Packaging Workflow

A high-speed filler and seamer cannot be evaluated in isolation. Depending on the project, the complete workflow may include:

  •  Empty-can handling and rinsing
  •  Beverage supply and pressure control
  •  CO2 supply
  •  Lid handling and seaming
  •  Conveyors and accumulation
  •  Date coding and exterior rinsing or drying
  •  Fill-level, package or seam inspection
  •  Reject functions
  •  Case or tray packing and palletizing
  •  Cleaning and sanitation equipment

A line can have sufficient rated filling capacity and still underperform if a connected section cannot support the intended workflow. That is why the project review should identify likely bottlenecks, control interfaces and operator touchpoints before the layout is finalized.

4. Confirm Facility and Utility Readiness

Facility preparation should begin before shipment. The final requirements depend on the selected configuration, but the planning discussion should review:

  •  Available floor space and line access
  •  Equipment delivery and rigging routes
  •  Electrical service
  •  Compressed air, CO2, water and drainage
  •  Beverage inlet conditions
  •  Network or equipment communication needs
  •  Operator, maintenance and sanitation access
  •  Space for credible future expansion

Utility requirements should be confirmed from the final equipment configuration and project drawings. Generic assumptions are not a substitute for an engineering review.

5. Define What the Factory Acceptance Test Should Verify

A Factory Acceptance Test should review the agreed project functions, not simply confirm that individual machines power on. Depending on the confirmed scope, the FAT may review:

  •  Filling operation
  •  Lid placement and seaming
  •  Conveyor movement and line balance
  •  PLC sequences and operating modes
  •  Sensors, alarms and safety functions
  •  Inspection or reject functions
  •  Communication between connected equipment
  •  Startup and shutdown behavior

The testing medium, container format, test duration, acceptance criteria and documentation should be agreed before the FAT. This creates a shared definition of what will be reviewed and reduces ambiguity during the test.

Factory testing does not replace onsite commissioning. It helps identify issues earlier and creates a stronger foundation for installation, startup and operator preparation.

6. Plan the Controls and Documentation Handoff

Controls affect daily operation, troubleshooting and long-term maintenance. A clear handoff should address the functions relevant to the selected system, which may include:

  •  Operator interface structure and production recipes
  •  User access levels
  •  Manual and automatic modes
  •  Alarm messages and response guidance
  •  Connected-equipment communication
  •  Available electrical drawings
  •  Backup and recovery procedures
  •  Troubleshooting documentation
  •  Remote-support requirements

The goal is to give the customer’s operators and maintenance team a clear understanding of how the system is intended to function and what information is needed when support is requested.

7. Separate Installation From Commissioning

Installation and commissioning are related, but they are not the same. Installation may include equipment placement, mechanical connections, electrical work, utilities and integration. Commissioning focuses on preparing the installed system for operation.

A project-specific startup checklist may include:

  •  Utility verification
  •  Mechanical and electrical inspections
  •  Communication checks between line sections
  •  Sensor, control and safety checks
  •  Startup-sequence testing
  •  Agreed can-format testing
  •  Operating-parameter review
  •  Acceptance-process confirmation

Responsibilities should be defined before the equipment arrives. The project documents should clarify what Redwood, the customer and any third-party contractor must prepare or complete, along with the agreed schedule and acceptance boundaries.

8. Prepare Operators for Startup, Changeovers and Cleaning

Even a technically capable line can experience avoidable startup delays if the operating team is not prepared. Training and startup guidance should be matched to the actual equipment configuration and customer requirements.

  •  Normal startup and shutdown
  •  Production monitoring
  •  Can and lid replenishment
  •  Product or format changeovers
  •  Cleaning and sanitation
  •  Routine inspections
  •  Alarm response and basic troubleshooting
  •  Documentation and support-escalation procedures

The format, location, duration, participants and supporting materials should be confirmed as part of the project scope rather than assumed after shipment.

9. Build a Configuration-Specific Spare-Parts Plan

A useful spare-parts plan should reflect the final equipment configuration. It may address startup spares, critical wear parts, sensors, electrical components, seamer-related items, format-specific change parts and routine maintenance items.

The project team should also confirm parts identification, recommended inspection intervals and lead times for critical components. A generic list is less useful than a plan tied to the equipment that will actually be installed.

10. Define After-Sales Support Before Shipment

Support expectations are easier to manage when they are documented before startup. Confirm:

  •  Primary support contacts
  •  Information required when reporting a problem
  •  Remote diagnostic procedures
  •  Documentation availability
  •  Spare-parts ordering process
  •  Warranty scope
  •  Conditions for field support
  •  Customer maintenance responsibilities

Response times, onsite support, remote support and warranty coverage should be stated in the final project documentation. They should not be inferred from general marketing language.

11. Prepare a Better Quote Request

A detailed inquiry gives the manufacturer better information for recommending equipment and defining the support scope. Prepare:

  1. Beverage types and product conditions
  2. Can and lid formats
  3. Packaged volume per run
  4. Packaging frequency and shift schedule
  5. Target production rate
  6. Available operators
  7. Upstream beverage-supply equipment
  8. Required downstream equipment
  9. Facility layout and available utilities
  10. Cleaning and quality-control requirements
  11. Target startup schedule
  12. Expected growth
  13. Required testing, training and support scope

Better project information reduces assumptions, improves quotation accuracy and helps align the proposed system with the operating plan.

Build the Project Around Successful Operation

A 100, 200, 300, or 600 CPM canning line should not be evaluated by machine price or headline speed alone. Successful operation depends on appropriate equipment selection, complete-line planning, meaningful factory testing, facility readiness, controls handoff, operator preparation, spare-parts planning and clearly defined technical support.

Redwood Stainless Systems works with beverage producers to define project requirements, plan equipment configurations, manufacture and test the agreed system, and establish an appropriate commissioning and support scope. The purpose is not simply to ship equipment. It is to help the customer prepare a production system that fits the product, facility, team and growth plan.

Planning a 100, 200, 300, or 600 CPM canning line? Share your beverage, can formats, production volume, packaging schedule, facility information and support requirements with Redwood.



FAQ

What support is included with a Redwood high-speed canning line?

Support depends on the selected configuration and confirmed project scope. Factory testing, installation coordination, commissioning, operator training, documentation, spare-parts planning and after-sales support should be reviewed during project planning and stated in the quotation.

Is rated CPM the same as actual finished output?

No. Rated speed is a planning reference. Actual finished output depends on product conditions, can format, equipment configuration, material supply, operators, cleaning, changeovers and overall line conditions.

What should be confirmed before commissioning?

Confirm the layout, utilities, beverage supply, container formats, connected equipment, controls integration, staffing, cleaning requirements, testing plan and acceptance criteria.

Why should FAT criteria be agreed before testing?

Agreed criteria give the customer and manufacturer a shared definition of the test scope, including the functions, medium, container format, duration and documentation that will be reviewed.

What information should be included in a quote request?

Include beverage type, production volume, packaging frequency, target CPM, can formats, labor, facility information, utilities, connected equipment, startup schedule, growth expectations and the required testing, training and support scope.
