What to Expect During Commercial Canning Line Installation and Commissioning
Share
Purchasing a commercial canning line is a major investment, but getting the equipment delivered is only the beginning of the project.
Whether you're installing a 50 CPM starter system or a 600 CPM high-speed production line, the success of the project depends on much more than the equipment itself. Proper planning, installation, commissioning, and operator training all play an important role in determining how quickly the line reaches stable production.
In our experience, the smoothest startups don't happen by accident. They begin months before the first can is filled, with careful planning, clear communication, and close coordination between the equipment supplier and the brewery or beverage producer.
---
A Commercial Canning Line Is More Than Individual Machines
When evaluating a commercial canning line, it's easy to focus on individual pieces of equipment—such as the filler, seamer, or conveyor system.
In reality, a canning line is a fully integrated production system where every machine depends on the others to perform efficiently.
A typical commercial counter pressure canning line may include:
- Depalletizer
- Can Rinser
- Counter Pressure Filler
- Seamer
- Conveyor System
- Warming Tunnel (if required)
- Date Coder
- Inspection Equipment
- Accumulation Table
- Packaging Equipment
Each station must operate in synchronization. If one component isn't properly integrated, it can affect the efficiency of the entire production line.
That's why installation and commissioning are just as important as equipment selection.
---
Planning Before the Equipment Arrives
One of the most common reasons projects experience delays isn't because of the equipment itself—it's because supporting infrastructure isn't fully prepared before delivery.
Before installation begins, beverage producers should verify several key areas:
- Electrical power requirements
- Compressed air supply
- CO₂ supply
- Water and drainage systems
- Utility routing
- Equipment access paths
- Floor layout and production flow
- Space for future maintenance and expansion
Addressing these items early helps minimize installation delays and creates a smoother startup process once the equipment arrives.
Planning ahead also gives breweries the opportunity to think beyond today's production needs and prepare for future growth.
---
Installation Is About System Integration
Installing a commercial canning line involves much more than positioning equipment on the production floor.
Each machine must be aligned mechanically, connected correctly, and integrated into the overall production workflow.
Typical installation activities include:
- Equipment positioning and leveling
- Conveyor alignment
- Electrical wiring
- Pneumatic connections
- Product piping
- Utility integration
- Safety verification
- Communication between automated equipment
Every connection influences the overall performance of the production line.
When installation is carefully planned, commissioning becomes significantly more efficient.
---
Commissioning Is Where Production Begins
Commissioning is the stage where engineering drawings become a working production line.
Before filling beverage, every major function of the system is verified to ensure it operates safely and consistently.
This process typically includes:
- PLC and HMI verification
- Sensor calibration
- Conveyor synchronization
- Filling accuracy
- Seaming performance
- Alarm testing
- Safety system verification
- Recipe configuration
Rather than immediately introducing product, many commissioning procedures begin with water testing and empty can runs.
Testing with water allows operators to verify flow rates, timing, equipment communication, and system stability while making adjustments before valuable product enters the line.
This approach reduces waste and helps identify small issues before commercial production begins.
---
Operator Training Is Part of Commissioning
Even the most advanced automated canning line depends on the people operating it.
A successful startup isn't simply about making the equipment run—it's about making sure the production team understands how to operate it with confidence.
Training typically includes:
- Daily startup procedures
- Product changeovers
- Cleaning and sanitation
- Routine maintenance
- Basic troubleshooting
- Monitoring seam quality
- Responding to system alarms
Well-trained operators contribute directly to production efficiency, equipment reliability, and long-term performance.
---
The Project Doesn't End When the Equipment Ships
One misconception we occasionally hear is that the project is complete once the canning line leaves the factory.
In reality, that's often when the most important phase begins.
For many of our projects, Redwood Stainless Systems continues supporting customers after installation through on-site commissioning and startup assistance.
Our engineers work alongside brewery and beverage production teams to verify equipment performance, review process flow, fine-tune operating parameters, and answer questions that naturally arise during the first production runs.
Sometimes the adjustments are minor. Sometimes it's helping operators become more familiar with the system. Other times, it's identifying small improvements that make day-to-day production more efficient.
These site visits also provide valuable feedback that helps us continuously improve future equipment designs.
For us, success isn't measured when the equipment leaves our factory.
It's measured when the customer is confidently running production and the canning line performs as expected under real operating conditions.
---
A Real Project Example

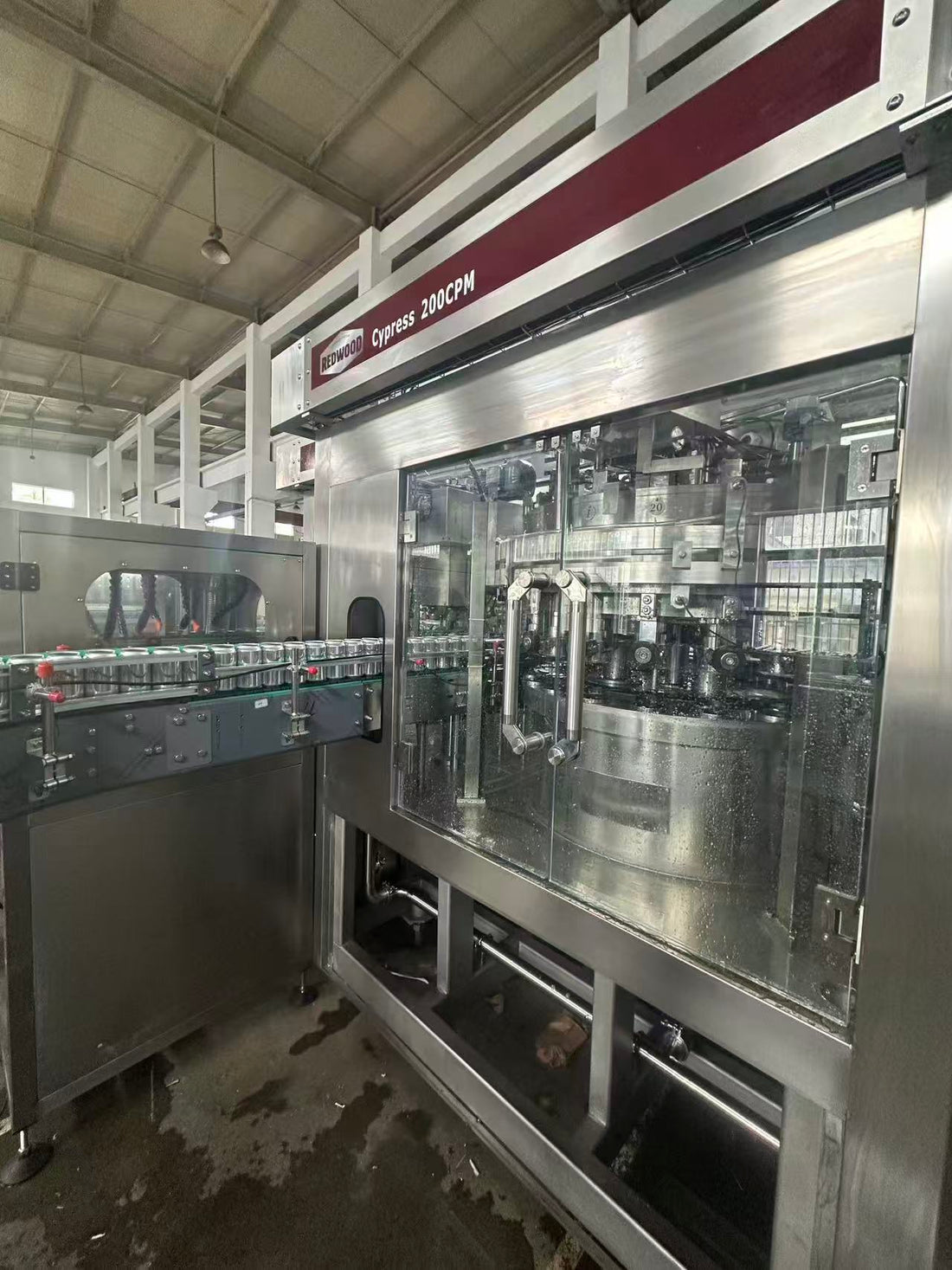

A recent example is our 200 CPM Counter Pressure Canning Line installed for Harland Beer.
From production planning and equipment manufacturing to installation support and commissioning, the project demonstrated how preparation and coordination contribute to a successful startup.
If you're interested in seeing how a commercial canning line comes together in a real production environment, explore our Harland Beer Canning Line Project.
https://redwoodstainless.com/blogs/news/cypress-200cpm-canning-line-project-for-harland-beer
---
Choosing the Right Partner Matters
A commercial canning line is more than a collection of machines.
It's an investment in your production capacity, product quality, and future growth.
Choosing the right equipment is important—but choosing a partner who understands planning, manufacturing, installation, commissioning, and long-term support can make the entire project more predictable and less stressful.
At Redwood Stainless Systems, we work with breweries and beverage producers throughout the entire process—from equipment selection and system design to manufacturing, delivery, installation support, and commissioning.
Our goal is simple: to help customers move from project planning to production with confidence.
